avgust 27, 2026

Balancing a production line without stopping the whole plant

Check station cycle time against takt right now: divide today’s available production time by demand, then compare that number to how long each station actually takes. If every station clears in less time than takt, you have room to rebalance by moving tasks between operators. If one station’s fixed work (a boulder, not a movable task) already runs longer than takt, no amount of reshuffling will fix it. You need process redesign or added capacity instead.

That fifteen-minute check tells you which game you’re playing before you waste a shift on the wrong fix.

  • Calculate takt: available time ÷ customer demand for the shift.
  • Compare each station’s cycle time to that number.
  • If a fixed operation (welding cycle, curing time, tooling limit) exceeds takt, plan redesign or parallel capacity, not reallocation.

Pro tip: A rebalance is realistic in a single shift when movable tasks make up more than 15 to 20% of the bottleneck station’s workload — below that, you’re looking at a redesign project, not an afternoon fix.


TL;DR:

  • Rebalancing is only effective if fixed work at a station does not exceed takt time, requiring redesign or parallel capacity for boulders.
  • Continuous cycle time measurement using MES enables real-time detection of imbalance, reducing reliance on quarterly audits or estimates.
  • Mapping the Yamazumi chart before task reallocation ensures teams target the true bottleneck, preventing misdirection from fixed process work.
  • Cross-training operators can turn fixed “boulder” tasks into movable “pebble” tasks, speeding up rebalancing and reducing the need for redesign.
  • Pilot testing rebalancing on a limited batch and updating routing and system data immediately is crucial to maintaining a balanced line.

Table of Contents

What is uravnoteženje proizvodne linije and why the terms matter

Line balancing (uravnoteženje proizvodne linije) means distributing work content across stations so each one finishes close to takt time, with no station starving the next or piling up queues behind it. Get the vocabulary straight first, because operators, engineers and planners often talk past each other using the same words differently.

  1. Takt time — available time divided by demand. If you run 420 minutes a shift and need 210 units, takt is 2 minutes per unit.
  2. Cycle time — how long a station actually takes to complete its task, measured with a stopwatch or, better, an MES.
  3. Yamazumi — a stacked bar chart showing each station’s task content against the takt line, making imbalance visible at a glance.
  4. Boulders vs pebbles — boulders are fixed, machine-paced or process-paced work you can’t easily shrink (a press cycle, an oven dwell); pebbles are manual, movable tasks you can reassign between stations.
Term Quick definition Why it matters
Takt time Available time ÷ demand Sets the target every station must beat
Cycle time Actual time a station takes Compared directly against takt
Yamazumi Bar chart of station workload Shows imbalance visually, station by station
Boulders Fixed, unmovable work Defines the ceiling rebalancing can’t cross

Pro tip: Draw the Yamazumi before you touch anything. Teams that jump straight to moving tasks usually rebalance around the wrong bottleneck because they never mapped where the real boulder sits.

Will reallocating tasks actually fix your bottleneck?

Run this test before committing resources: identify the slowest station, then check whether its excess time comes from a boulder or a stack of pebbles. Rebalancing only works on the second case. Balancing succeeds only when the fixed work at a station doesn’t exceed takt — once it does, the process itself needs redesigning or running in parallel, because no reassignment of manual tasks touches a machine cycle.

Hidden boulders hide in places engineers overlook:

  • Oven or curing dwell times that can’t be rushed without ruining the part.
  • Changeover time baked into a “cycle” figure that actually belongs to setup, not production.
  • Tooling or fixture limits that cap how fast one machine can run, regardless of operator skill.
  • Machine-paced automation cells where cycle time is fixed by the equipment vendor’s spec, not your layout.

Mixed-model lines add another layer. When several product variants share a line, WIP buffers between grouped stations absorb short-term imbalance, and parallel station groups can each be balanced independently to their own CTmax objective rather than forcing one line-wide number. A documented automotive case used exactly this grouping approach, treating clusters of stations as parallel sub-lines rather than one continuous chain.

How to rebalance a line in a single shift

You don’t need a six-month project to rebalance most lines. Follow this sequence and you can pilot a change before the shift ends.

  1. Measure. Pull cycle times from your MES if you have one; a stopwatch and clipboard work too, just expect more noise. Calculate takt from your actual shift length and confirmed demand, not a rounded estimate.
  2. Map. Build the Yamazumi chart, marking every task as boulder or pebble. This step alone usually reveals which station is the true bottleneck, not the one everyone assumed.
  3. Plan the moves. Reassign pebbles between adjacent stations, respecting task precedence (you can’t paint before you weld). Where two small tasks combine neatly onto one operator, merge them; where one task overloads a single station, split it.
  4. Pilot. Run the new allocation on a limited batch. Watch three numbers: throughput against takt, queue length between stations, and defect rate. A rebalance that speeds up flow but spikes rejects has failed, not succeeded.
  5. Roll out and update standards. Once the pilot holds for a full run, update routing, standard work instructions and your ERP or MES capacity data so the new allocation becomes the default, not tribal knowledge held by one shift leader.

Pro tip: Photograph or export the Yamazumi before and after every pilot, and keep both versions on file. When a rebalance needs rolling back six weeks later, you want the exact “before” state on record, not a memory of what it looked like.

Step What “done” looks like
Measure Cycle time and takt calculated from current, real data
Map Yamazumi drawn with boulders and pebbles marked
Plan moves Reassignments respect precedence and skill requirements
Pilot Throughput, queue length and defects tracked together
Roll out Routing and MES/ERP records updated to match the new standard

Which balancing method fits your line’s complexity

Formal models exist for a reason, but most plants only need them at the edges. The elimination method groups operations by precedence and iteratively assigns the minimal-loss set to each station, a technique that’s been taught in production systems courses for decades because it’s transparent enough to do by hand on a whiteboard.

  • SALBP (Simple Assembly Line Balancing Problem) formalises the two classic objectives: minimise stations for a fixed takt (SALBP-1) or minimise cycle time for a fixed number of stations (SALBP-2).
  • SALBP variants are proven NP-hard, meaning exact solutions get computationally expensive fast. Use exact models on small, high-value lines; use heuristics once you’re past a dozen or so stations.
  • An MES turns this from a periodic exercise into a live one. Instead of scheduling a kaizen event once a quarter, automated cycle-time capture and dashboard alerts flag imbalance the day it appears.

Real-time data doesn’t just speed up measurement, it changes the rhythm of the whole practice. Balancing stops being an event you schedule and becomes something you check continuously, the same way you’d watch a fuel gauge rather than calculate range once a month.

Keeping the line balanced after the fix

A successful rebalance decays without monitoring. Build these checks into daily routine, not an annual audit.

  • Track takt, station cycle time, CTmax, OEE, queue length and lead time on one dashboard, not scattered spreadsheets.
  • Give operators a clear SOS trigger: if a station falls behind for more than a set number of cycles, they escalate to the shift leader immediately, not at the next meeting. This escalation habit is what separates lines that stay balanced from ones that drift back within a fortnight.
  • After any confirmed rebalance, update routing, standard work documents and MES/ERP entries the same day, while the change is still fresh in everyone’s memory.

Why an MES changes how quickly you can rebalance

Stopwatch audits tell you what happened last Tuesday. An MES tells you what’s happening on station four right now, and that difference determines whether you catch drift in an hour or a month.

  • Live cycle-time capture removes the guesswork from your Yamazumi. You’re plotting what actually happened, not what an operator estimated at lunch.
  • Downtime and quality events flow into the same dashboard, so you can tell whether a station is slow because of workload or because a machine keeps faulting.
  • Alerts flag stations drifting past takt as it happens, which is what lets a documented automotive case cut lead time from 235.18 to 198.51 minutes while lifting group balancing efficiencies into the high nineties.
  • Version history on routing and Yamazumi snapshots gives you an audit trail, so a pilot that doesn’t work out can be rolled back cleanly.

That shift, from quarterly kaizen event to daily practice, is the single biggest change real-time data brings to balancing work.

Why the same rebalance fails on one line and works on another

Skill spread across your workforce decides how much of your Yamazumi you can actually rebalance. A pebble that takes a trained operator forty seconds might take a new hire ninety, and if your rebalance plan assumes uniform skill, it will fail the moment you rotate staff.

Hands performing skilled assembly on production line

Cross-training changes what counts as a movable task in the first place. A station that looks like a boulder because only one person on the floor can run it stops being fixed once two or three operators are qualified on it. That’s not a process redesign, it’s a training investment that turns a hard constraint into a flexible one, often more cheaply than adding equipment.

The reverse also holds. Rebalance a line assuming interchangeable operators, and put an undertrained person on the new bottleneck station, and you’ve traded one imbalance for another that your Yamazumi chart won’t show until defects start climbing.

Build skill matrices into your balancing decisions the same way you’d map machine capability. Before moving a pebble to a new station, check who’s actually qualified to absorb it, and whether that qualification needs topping up first. Lines with broad cross-training recover from rebalancing faster because more of the workforce counts as flexible capacity rather than fixed capacity, which is really the same boulders-versus-pebbles logic applied to people instead of machines.

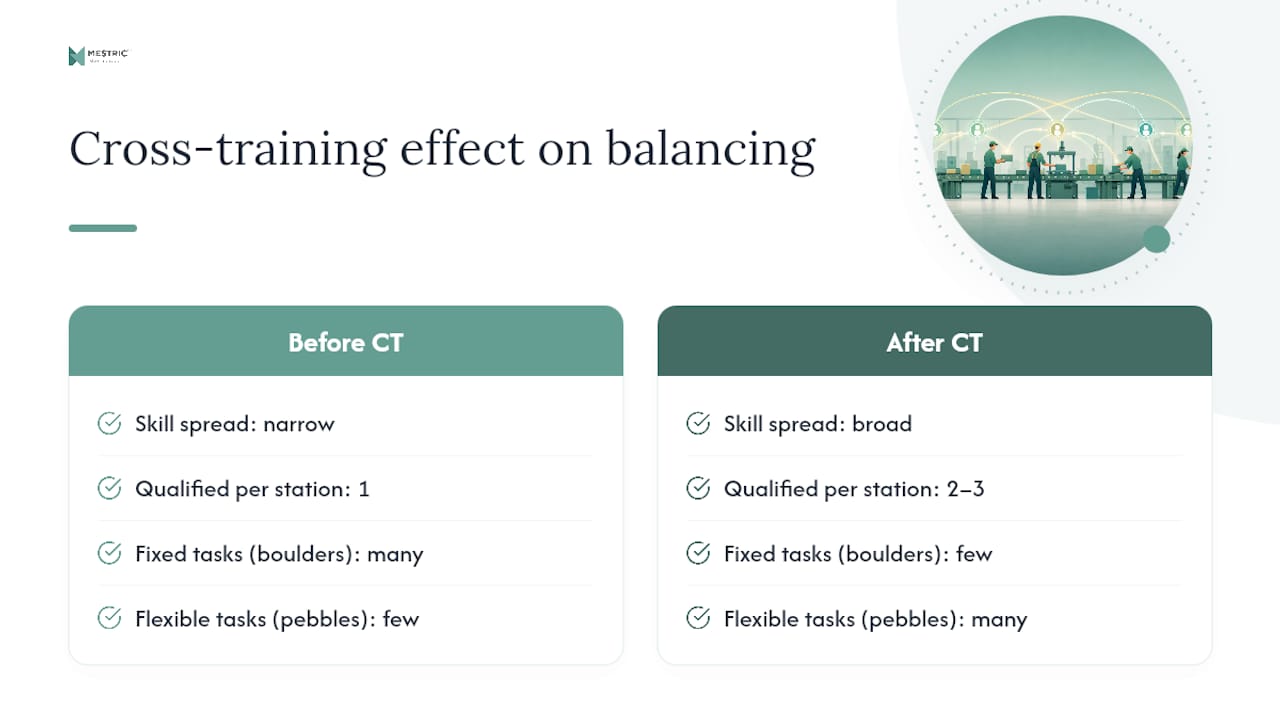

Diagram of operator qualification and line balancing effect

What most balancing advice gets wrong

Most guidance on this topic treats balancing as a project: schedule a kaizen event, bring in a facilitator, spend a week with stopwatches, present a new Yamazumi, move on. That model isn’t wrong, it’s just incomplete, and the gap shows up six weeks later when the line has quietly drifted back out of balance and nobody noticed until output slipped.

The bigger error is skipping the triage step. Teams reach for reallocation before checking whether the bottleneck is even a pebble problem. Move tasks around a boulder for a week and you’ll produce a tidier-looking Yamazumi chart with exactly the same throughput ceiling you started with.

What I’d prioritise first: stop treating measurement as a one-off event. The plants that stay balanced are the ones checking cycle time against takt daily, not quarterly, which is only realistic with continuous data rather than a stopwatch and a clipboard. Get that cadence right before worrying about which algorithm sequences your task moves.

— Andraž

Get continuous balance data instead of a once-a-quarter snapshot

Everything in this article depends on knowing your real cycle times, not estimated ones, and that’s exactly where Mestric fits. Rather than scheduling stopwatch audits and hoping the Yamazumi still reflects reality by the time you act on it, Mestric captures cycle time, downtime and quality events directly from connected machinery, so your balance data updates as the shift runs, not after it ends.

Mestric

That’s the practical difference for a plant manager coming from this article: you can pilot a rebalance and see the throughput, queue length and defect impact on the same day, instead of waiting for next month’s report to confirm whether the change worked. If you’re ready to see how real-time performance tracking applies to your own line, book a demonstration and bring your current Yamazumi chart. It’s the fastest way to find out where your actual boulders are.

Key Takeaways

A production line stays balanced only when teams measure cycle time against takt continuously and separate fixed boulders from movable pebbles before reassigning any work.

Point Details
Check takt first Compare every station’s cycle time to takt (available time ÷ demand) before changing anything.
Separate boulders from pebbles Fixed process work above takt needs redesign or added capacity, not task reallocation.
Pilot before rolling out Test a rebalance on a limited batch and check throughput, queue length and defects together.
Update your systems Refresh routing, standard work and MES/ERP entries the same day a rebalance is confirmed.
Use continuous MES data Mestric captures live cycle-time and downtime data so rebalancing becomes a daily check, not a quarterly project.
